Construction work for the eight blasting pylons for the purpose of securing the slopes on the Plattenhorn/Hörnli started in mid-July 2023. The construction of the mast foundations in the steep and difficult-to-access terrain is demanding and requires some preparation and expertise. The blast masts will replace the previous Avalancheur system with explosive darts.

Initial situation
In the Hörnli-Plattenhorn ski area section, the important transfer slope runs along the southern flank. Large snow deposits are frequent there after heavy snowfalls with wind, which is why the section of the track and the rail facilities between Hörnlistein and Gampibach (Plattenhorn altitude) have been blasted by the patrollers of Arosa Bergbahnen AG using the Avalancheur system since 2013. These explosive darts with nitrogen are composed of three parts. With this, the Piste/Rescue Service (PRD) advises a total of 15 targets in the Hörnli/Plattenhorn area. The blasting is personnel and cost intensive. The liquid explosives are assembled by hand, and the blasting team, consisting of two patrollers and one railroad employee, must independently climb the mountain to prepare and trigger the blast. One blasting dart or shot costs CHF 500.00 for one target. After triggering the blast, aluminum residues remain, which are collected in the spring.

Project description
After the very good experiences with the new blasting system on the Brüggerhorn (two blasting masts with synthetic explosives and automatic triggering), the Arosa Bergbahnen have developed a concept for the replacement of the Avalancheur blasting. Instead of 15 blasting targets, this concept provides for only eight. The eight avalanche blasting masts will be built on a concrete foundation. Each blasting mast has 12 5 kg charges. The charges can be activated by GPS transmission with remote triggering. This method has been tried and tested in numerous snow sports areas and is considered the standard solution. The advantages are that a blast can be triggered at any time and regardless of the weather, personnel costs are significantly reduced and work safety is significantly increased. In addition to the time saved, no residues remain on the ground.

The blasting pylons cost CHF 110,000 each, plus the foundation costs of around CHF 25,000. This results in total costs of around CHF 1.1 million for the final construction of all eight blasting sites. Arosa Bergbahnen will proceed in stages and construct all foundations for the eight sites in summer 2023 and equip the first two sites on the Plattenhorn with blasting pylons. In the following years, the aim is to fully equip all sites.






Arosa Bergbahnen is investing CHF 3.4 million in the widening of piste 9a between Carmenna Mitte and LAW mid-station with terrain corrections and the replacement of the old snow-making system. The progress of construction is very pleasing. The work will be completed by the end of September 2022.

With the realisation of the Arosa Lenzerheide ski region’s connection to a single large ski resort in winter 2013/2014 (opening on January 18, 2014), the two destinations significantly strengthened their international competitiveness. In addition to the size of the ski as the most important decision criterion when choosing the destination, snow reliability is the next decisive factor for the guest, especially in view of international competition.

Arosa Bergbahnen AG focuses its development on the qualitative improvement of the existing product range and the quality of service. Improved product quality includes ensuring technical snowmaking on the existing slopes to guarantee snow reliability throughout the main winter business from December to April. In addition, existing bottlenecks and safety deficiencies must be eliminated with selective terrain corrections. As a welcome side effect, the terrain corrections demonstrably result in lower expenses for the slope construction (snowmaking) and preparation with reductions in water usage and diesel consumption, as well as pasture improvement for alpine farming in summer.

Initial situation
The Carmenna chairlift connects the two ski resort zones Arosa West (Hörnli-Plattenhorn) and Arosa East (Weisshorn-Tschuggen-Brüggerhorn). The piste 9a from Carmenna middle station to LAW middle station is the central transfer piste and of great importance for snow sports enthusiasts in getting from the West to the East side. The planned terrain adjustments widen today's very narrow piste, eliminate safety risks and improve the transparency for snow sports enthusiasts. Modernising the snowmaking system will also increase snow efficiency and considerably simplify the provision of pistes.

Project description
Over a distance of approx. 870 m, the narrow, existing piste route between Carmenna middle station and LAW middle station, which is equipped with an old snowmaking system, will be widened to 15 m. The area concerned is approx. 15,000 m2. At the same time, the snowmaking system is being modernised. The cubage of the earth material to be removed amounts to a total of around 19'000 m3 (correction in mass balance).

In consultation with the landowner (civil community Chur), these works will be carried out immediately after the thawing period in spring 2022 (from mid-June). The earth shifts are carried out by a local construction company with the support of employees from Arosa Bergbahnen AG. For the replacement of the snowmaking system in this section, specialist personnel from Technoalpin will be consulted. The responsible employees for project support and control work in the piste/rescue service in winter and are very familiar with the terrain. They guarantee an optimal and most gentle execution of the slope corrections, as proven with previous projects of terrain corrections (Traxloch, toboggan run, ski lift track, Strohkurve, piste 12 Brüggerhorn). The removed earth material is reintroduced in the immediate vicinity without the need for material to be removed or added. The corrected area will be fenced until complete greening is ensured.

Three cooling towers (3 m x 3m x 3 m) will be installed on the North-Western shore of the reservoir. They are used to cool the reservoir water in early winter, allowing a water supply into the snowmaking system at the desired temperature.

Justification/Benefits
The terrain or piste correction eliminates an existing safety risk below the "Briggerhang" with the removal of the peak and improves the transparency at the intersection of piste 9a (from Carmenna middle section) with piste 10a (from Weisshorn-Traxloch). The straightening of the narrow section with a left turn above the reservoir defuses this "bottleneck" and allows a more even slope width, which reduces the formation of humps, significantly improves the flow of guests and reduces the risk of accidents. Likewise, the intersection of piste 9a with the LAW middle section-Sattelhütte hiking trail creates a noticeably better perception and visibility for skiers and winter hikers with the widening. Families and ski schools also actively use this section of the slope. The terrain adaptation ensures more safety for less experienced snow sports enthusiasts and families with children.

Piste 9a between Carmenna middle station and LAW middle station is well frequented by snow sports enthusiasts. This section of the slope is already fully covered with artificial snow. The removal of peaks and the filling of hollows significantly reduces the effort for technical snowmaking, as well as daily slope preparation. It is a proportionate intervention which impairs the landscape to a tolerable extent. The terrain corrections also achieve a desired improvement in pastureland, which is in the interest of the civil community Chur as the landowner and user of the alpine pastures.

Implementation
The earthworks and master builder work was carried out by the local ARGE Brunold/Allemann, while Technoalpin was responsible for the delivery, laying and installation of the snowmaking system. The construction group of Arosa Bergbahnen provided support. The external environmental construction supervision continuously assessed the project execution. The partners involved worked very well together, so that the time schedule could be kept - also thanks to the almost continuously beautiful summer weather. The result is impressive; the terrain corrections fit in harmoniously with the surroundings.





Arosa Bergbahnen AG is introducing the third staging element in the multi-year concept of the snowsports experience world at Tschuggen for the coming winter with the «Zappelbär» search game. The concept of the Snowsports World of Experience aims to promote the next generation of snowsports enthusiasts. The first stage was implemented in December 2017 with «Honeyland» on Prätschli. In the latest play element, the «Zappelbär» fumbles around cheerfully in the Tschuggen area. Yet, he should have long since found his winter rest. Starting in December, the youngest snow sports enthusiasts will accompany him on the «Zappelbär» search game and help him get tired.

The high-quality staged and lovingly designed bear search game begins on Tschuggen. The starting portal with game instructions is installed there. Children between 4 and 12 years of age are invited to complete this post run on skis or snowboard with their companions. The individual posts are marked on the back of the game card. Attention and a good eye are necessary because the posts are to be explored somewhat hidden at the edge of the slope. In between, a welcome rest on the uphill ride with one of the railroads comes just in time. The fidget bear eats his winter fat with sweet honey, mushrooms or a bush full of blueberries. On the way he meets the mouse in the burrow, the snow grouse in the warm bed and the squirrel counting cones. At the individual posts, the aim is to open the lock to the punch card using the humorously designed game instructions. Once all the stamps have been collected on the playing card, the fidget bear is ready for its winter rest. And for the children there is a fine reward when they visit the restaurants Tschuggenhütte or Brüggerstuba.

The opening of the «Zappelbär» search game is planned for Christmas. The exact date is yet to be announced. Arosa Bergbahnen AG is investing CHF 150,000 in this impressive experience.



Piste 12 Beschneiung



"Black  Diamond Slope" (Piste 12) - snow sports treat at the Brüggerhorn
The "Black Diamond Slope" starts at the top of the Brüggerhorn in 2,447 m above sea level. The slope branches off eastwards above the monument slope. Below the Brüggerhorn-Schulter, the slope carries on gently, coupled with a dreamlike panorama to the start of the truly steep slope. This one is quite something.  After turning into the Tomelitäli, the slope ends at the Tomeli Valley ski lift.

With the technical snowmaking at the «Black Diamond Slope», the Brüggerhorn offers pretty much all downhill options to make the snow athlete's heart beat faster. These include the red slope 10 via Sattelhütte-Traxloch middle station, the panoramic slope Leichte Maran 11 (blue), the yellow descent 12a (secured, marked, but not prepared) through the Tomelitäli, and, of course, the black slope 12 Diamond Slope for the ambitious snow athlete.

How did the naming come about
How did the "Diamond Slope" or "Black Diamond Slope" get its name? The naming of the slopes in the snow sports area Arosa usually originates from the creative ideas of the employees of the slope/rescue service. The veteran slope patroller Willi Kuhn, who died in April 2011 and had to leave us far too early, took up the idea of the American name for the slope. There, one has so-called "double black" slopes. He did not like this name very much, since the challenging steep slope on the Brüggerhorn actually only describes one character of this new slope. The new slope preparation is very varied and has so much to offer in terms of the terrain and the views that it reminds more of the peculiarity of an uncut diamond. Willi Kuhn's proposal to name the slope 12 “Black Diamond Slope” as a diamond slope was unanimously accepted. Unfortunately, Willi didn’t have the opportunity to test the finished Diamond Slope.

Baptism of Fire 2012
The Arosa Bergbahnen AG created this attractive route in the terrain many years ago. However, the previously necessary gentle terrain corrections were delayed until Summer 2011 due to a delayed approval procedure, when finally the earthworks were carried out. For the preparation of the approximately 2.4 km long slope, one thing was required above all before the first opening: a lot of natural snow. Just a few months after the completion of the terrain correction, the snowfall volume on January 2, 2012, amounted to 2.3 m after abundant fresh snowfall. Shortly afterwards, the Black Diamond Slope experienced its baptism of fire, and the snow sports enthusiasts were delighted with the new slope. After that, the slope was never prepared again due to the lack of natural snow until the comeback year 2018. It was marked in the official slope plan as a yellow route (marked and secured, but not prepared) and open to snow sports enthusiasts who wanted to use the slope even with less snow.

The comeback of the “Black Diamond Slope” in January 2018
The snowy winter made it possible. The Diamond Slope at the Brüggerhorn made a comeback on January 26, 2018. For the first time in 6 years, the Arosa Bergbahnen was in the position to prepare this attractive black piste at the end of January. Since the beginning of the year, and after the vast amounts of fresh snow in November/December (total 2.70 m), the management had been checking the chance of a slope preparation. After further snowfall in the first week of January 2018, they decided to include the attractive black "Diamond Slope" in this year's program.

Together with the necessary amount of natural snow, the slope construction is challenging. Especially the steep slope is complex in terms of preparation. The slope preparation takes about 7 days. Since no technical snow can be produced, the snow on the steep slope must be pressed and carefully solidified. The daily preparation of slope 12 takes between 6 and 7 hours. The lift companies to expand the vehicle fleet with an additional rented snow groomer. The additional costs for the "Diamond Slope" in winter 2017/18 amounted to around CHF 100,000.

... and once more in January 2019
Winter 2018/19 was similarly snowy. The snowfall was somewhat more delayed than in the previous year but very intense. From January 3, 2019, one saw a period of frequent snowfall, and January fulfilled all the wishes of those who can never have enough snow. Meteo Switzerland reported on January 14, 2019, with 180 cm in the village the most substantial measured amount of snow in Arosa in 70 years at this early time of the year. Ideal conditions to prepare the "Black Diamond Slope" once more. On January 31, 2019, the time had come: the opening for all snow sports enthusiasts who were delighted with the repetition slope offerings.

"Black Diamond  Slope" forever – the project for technical snow making in the Winter 2020/21
Following the realisation of the Arosa Lenzerheide ski area connection, Arosa Bergbahnen AG is focusing on the qualitative development of the snow sports area in the Arosa area. In the course of the planning approval process for the Arosa Lenzerheide connection, the lift company had to make concessions for the extension of the ski area (no development Ochsenalp), thus directing the flow of skiing guests to the slopes and areas of use that have existed for many years. The construction of the new 6-seater chairlift Brüggerhorn in summer 2019 and further planned measures to strengthen the Arosa-East area are intended to improve product quality. This includes the expansion of technical snow making on existing slopes to ensure guaranteed snow for the main winter business between December and April. The project for the technical snow making on the black slope 12, which is the most attractive snow sports slope in the Arosa area, is a unique selling point from a skiing point of view and part of the basic offering in the main ski area.

Qualitative service development on the mountain
The system-independent and unsupported commuter railway between Hörnli and Urdenfürggli (Urdenbahn) is the heart of the new Arosa Lenzerheide ski area connection. The two lift companies, appear together as one snow sports area with the winter brand "Arosa Lenzerheide". As a consequence, the connecting railway (Urdenbahn) is a connecting element between the two destinations Arosa and Lenzerheide from the start of the winter season (at the end of November) to the end of the season (around mid-April) in continuous operation.

To ensure good snow sports from the end of November to mid-April, the technical snow making on the slopes is essential. With the partial revision of the local planning at the Hörnli/Brüggerhorn site in 2014, the prerequisites were created to increase snow safety further. The concentration of forces aims to improve the quality of products and quality of services rather than quantitative expansion. The improved quality of the products also includes the expansion of technical snow making on existing slopes, ensuring guaranteed snow for the main winter business from December to April.

Increase in proportion of snow making on slopes
After the completion of the general development plan for snow making in 2007, about 58.74 ha of snow-covered slopes were available in the Arosa snow sports area. Looking at a total slope area of 120 ha, this corresponds to coverage of almost 50%. The additional snow making areas at Hörnli and Brüggerhorn, as defined in the usage planning, are virtually without exception between 2,000 m and 2,500 m above sea level. With the realisation of the planned snow making facility on the Brüggerhorn as the 3rd stage of expansion, the proportion of slopes with artificial snow in the Arosa snow sports area will increase from 50% to 75%. With this range of usable slopes, the lift company meets the customer's expectations for a secure snow sports operation and the competitiveness to competitors in neighbouring South Tyrol and Austria (snow making level >80 %). All projected snow making facilities are located on intensively used and prepared ski slopes. No additional slope planning is necessary.

The black slope 12 is an attractive alternative to the other slopes in the Weisshorn/Brüggerhorn region with the artificially snowed slope No. 10 from the Weisshorn summit to the middle station. This section of slope increases the variety of options: Arosa has only an 8% share of the total slope offerings, with demanding black slopes. With the replacement of the 49-year-old Brüggerhorn 2-seater chairlift in summer 2019 with a new comfortable and modern 6-seater chairlift on the same lift line from the middle station, the Brüggerhorn will undergo a significant upgrade in the Winter 2019/20. Train frequencies in December and January 2020 increased by 60% compared to previous peaks. On the other hand, the disadvantage is that the flow of guests from Brüggerhorn cannot be routed via slope 12 or the «Leichte Maran» 11 slope with modest amounts of natural snow, and thus sees a strong concentration of skiers on slope 10.

Environmental aspects
The snow making facility on the Brüggerhorn is located on the already used slope or route within the winter sports zones, which are preloaded with corresponding transport facilities, operational buildings, signal stations, etc. Runway 12, which is intended for snow making, is prepared by machine. In the environmental impact report on the GEP, planners already consider nature conservation zones and inventoried conservation areas for the development of the overall concept. This includes various measures to protect the environment, such as the restriction to the most important areas, no pipelines through valuable wetlands and nature reserves, or the minimization of noise emissions with optimized lines and choice of snow making units. With environmental organizations and landowners, the management was specified during an inspection in Summer 2014 as part of the partial revision to the local planning.

Water supply
Compared to the initial situation during the partial revision of the Hörnli/Brüggerhorn planning, the situation regarding water supply and water availability for technical snow making has improved significantly in Summer/Autumn 2019. The joint project of the municipality of Arosa and Arosa Bergbahnen AG with the new construction of the promenade pumping station aims to use the groundwater lake Isel to increase the fire water reserve for the inner Arosa area, and to improve the snow efficiency of the technical snow making. The construction work was completed in November 2018, and groundwater could already be used for technical snow making in the Winter 2018/19. The additional water supply of 60 l/s has the positive effect that the construction of another reservoir can be omitted.

In principle, Arosa Bergbahnen AG provides for technical snow making on the Brüggerhorn, slope 12, with mobile snow generators. Due to its preferred topographical location with lower temperatures, the lift company expects more favourable conditions and more efficient use of technical snow making. Slope 12 will be integrated into the snow making concept for the development of the Arosa snow sports area and will occupy a central position in the Arosa East area. Combined with the aim to open the attractive slope 12, if possible, on Christmas day. After completion of the initial snow layer, it is planned to dismantle the snow generators and install them on other sections of the slopes.

Technical data
The snowmaking pipe starts at the top station of the Brüggerhorn chairlift and leads to the valley station of the Tomeli ski lift via Tomeli-Täli. From there, the guest arrives at the Tschuggen, where he finds numerous downhill variants.

Pipe diameter: 100 mm to 250 mm
Depth:  1.60 m (frost depth)
Length:     2'467 m
Snow making area: 5.23 ha
Construction time:   approx. 14 weeks (70 working days)
Execution date:   from the beginning of July 2020 to mid-October 2020


Avalanche protection with detonation towers
In the upper section of the terrain between Brüggerhorn mountain station and "Pyramid" (field name), the slope runs along a northern flank for about 400 m. There, larger snow deposits are common after heavy snowfall with wind. Hence, this section of the slope has to be secured with altogether two avalanche detonation towers. These are erected on a concrete foundation. Each detonation tower has 12 explosive charges of 5 kg each. The charges can be activated by GPS transmission with remote triggering. This method has been tested in numerous snow sports areas and is considered as a standard solution.

Expiration of construction activities
Two types of construction equipment are used for the trenching and laying work to carry out the work from the Brüggerhorn mountain station and Arlenwaldstrasse. A crawler excavator opens the trench, the pipes are inserted, and the second crawler excavator closes the trench. The two avalanche detonation towers are erected in the terrain by an external specialist company. The electrical development of the snow making facility is carried out in close cooperation with the local energy supply company Arosa Energie.

Plan Beschneiung Piste 12

Costs
Based on the planning documents and inspections at the site in Summer 2019, rough cost estimates were given, or indicative offers for the planned snow system requested. The entire project is based on an assumed price base as per January 2020, which should be close to the effectively expected costs:

No. Service providers   Costs in CHF (excl. VAT)
1 Techno Alpin (manufacturer, supplier of technical snowmaking 1’980’000
2 Construction work (route/digging, pumping station outflow) 750'000
3 Arosa Energy, electrical access with transformer station 950'000
4 Swiss Heli,  Transport flights 135’000
5 Detonation towers 300'000
6 Planning,  permits,  environmental construction support 20’000
7 Arosa Bergbahnen AG, own services 90’000
8 Reserve 200’000
  Total excl. VAT 4'425'000
  Total incl. VAT 4'766'000

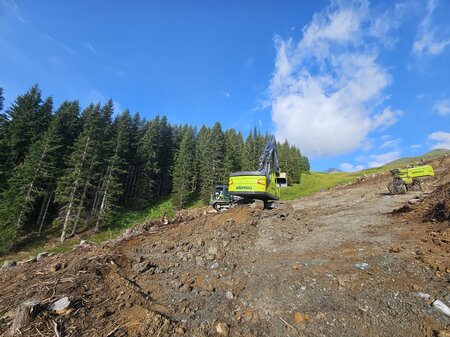

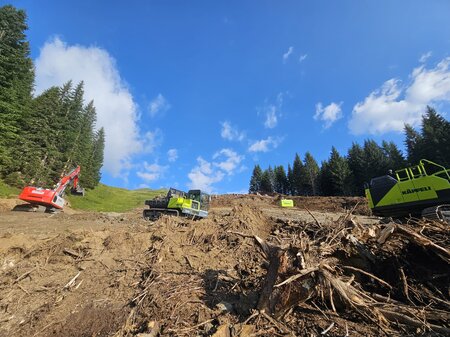

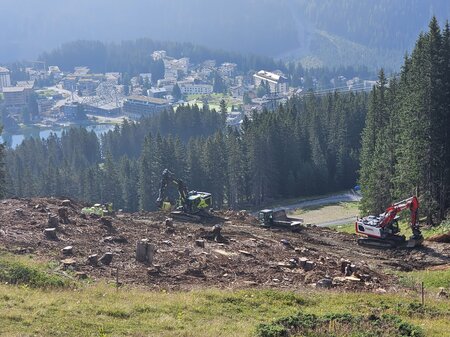

Photos from 20 July 2020: work in progress
Beschneiung Piste 12 Beschneiung Piste 12

 Piste 12 Beschneiung Piste 12 Beschneiung

Photos from 21 November 2020:
Black Diamond Slope - Piste 12  Black Diamond Slope - Piste 12

Press release "Opening, 19 December 2020"
